Planning a tenant fitout in Melbourne without a licensed electrician involved from the start is one of the most expensive mistakes a business owner can make. The question of why tenant fitout needs electrician involvement is not just about plugging in power points. It is about legal compliance, load calculations, landlord approvals, and avoiding the kind of costly rework that derails opening dates by months. Victorian law is clear: all commercial electrical work must be performed and certified by a licensed electrician. This guide explains exactly what that means for your fitout, from first design to final inspection.
Table of Contents
- Understanding electrical requirements for tenant fitouts in Melbourne
- Common challenges and consequences of inadequate electrical planning
- Why only licensed electricians should handle tenant fitout electrical work
- Electrical services integration in tenant fitout project stages
- Summary: why hiring an electrician is crucial for Melbourne tenant fitouts
- Why early electrician engagement beats waiting to the fitout phase
- Electrical Powerhaus: your partner for Melbourne tenant fitout electrical needs
- Frequently asked questions
Key Takeaways
| Point | Details |
|---|---|
| Licensed electricians are mandatory | Melbourne regulations require tenant fitout electrical work to be done by licensed professionals to ensure safety and compliance. |
| Proper design avoids costly issues | Upfront load calculations prevent overloads and expensive electrical upgrades after construction. |
| Early planning saves time | Starting electrical design before lease signing reduces approval delays and inspection failures. |
| Inspections and permits critical | Building surveyor certifications and occupancy permits depend on verified electrical compliance. |
| Professional coordination needed | Electricians ensure electrical systems integrate smoothly with mechanical and structural fitout elements. |
Understanding electrical requirements for tenant fitouts in Melbourne
Every commercial tenant fitout in Melbourne operates within a strict regulatory framework. The primary standard is AS/NZS 3000, commonly called the Wiring Rules, which sets mandatory requirements for how electrical systems must be designed, installed, and verified in commercial buildings. These are not guidelines. They are legally enforceable standards.
Working with commercial electricians in Melbourne who understand AS/NZS 3000 is essential because the rules cover far more than basic wiring. They govern circuit protection, earthing, load distribution, and safety switching. Get any of these wrong and your fitout will not pass inspection.
All commercial tenant fitouts in Melbourne must have electrical installations designed, installed, and verified by licensed electricians to ensure safety, with load calculations preventing overloads. Load calculations are particularly important in older Melbourne buildings, where the existing electrical infrastructure may not support the demands of modern office equipment, commercial kitchens, or retail lighting.
Beyond AS/NZS 3000, there is a building approval layer that many tenants do not anticipate. Electrical changes require base-building engineer sign-off and building surveyor certification before occupancy permit issuance, typically taking three to six months. That timeline surprises most first-time fitout tenants.
Key electrical requirements for Melbourne tenant fitouts include:
- Compliance with AS/NZS 3000 Wiring Rules for all new circuits and switchboard modifications
- Load calculations submitted to the base-building engineer for approval
- Coordination with the building’s existing electrical infrastructure and metering
- Certified electrical safety and compliance documentation before occupancy permit issuance
- Safety switch (RCD) installation on all circuits as required under Victorian regulations
“Electrical design is not a box to tick at the end of a fitout. It is a foundational element that shapes the entire project timeline and budget from day one.”
Common challenges and consequences of inadequate electrical planning
Poor electrical planning is the single most avoidable cause of fitout delays in Melbourne. Yet it remains surprisingly common, particularly among tenants who treat electrical work as a late-stage task rather than an early priority.

Commercial fitouts fail inspections most often due to inadequate upfront load calculations under AS/NZS 3000, which experts say should be done before signing leases. This is a significant finding. By the time most tenants engage an electrician, the lease is already signed and the building’s electrical limitations are locked in.
The consequences of inadequate electrical planning are real and measurable:
- Failed inspections caused by missing bonding connections, incorrect circuit breaker ratings, or circuits that exceed permitted load limits
- Costly rework when electrical work must be redone to meet AS/NZS 3000 after initial installation
- Project delays of weeks or months when inspection failures require redesign and re-approval
- Unexpected upgrade costs when older buildings require new switchboards or supply upgrades to support the fitout’s electrical load
- Coordination failures between electrical and mechanical trades, such as HVAC systems and lighting controls, that result in non-compliant installations
Preparing for electrical inspection in Victoria requires documentation, correct installation, and verified compliance across every circuit. Without a licensed electrician managing this from the start, gaps appear quickly.
Pro Tip: Before signing your commercial lease, ask the building manager for the existing electrical load schedule. A licensed electrician can review it in under an hour and tell you whether the building’s supply can support your planned fitout. This single step can save you tens of thousands of dollars.
“The most expensive electrical problems in tenant fitouts are not the ones that fail inspection. They are the ones nobody checks until it is too late.”
Visit the electrical compliance blog for more practical guidance on avoiding common fitout pitfalls in Melbourne.
Why only licensed electricians should handle tenant fitout electrical work
There is a persistent misconception that a general builder or project manager can oversee electrical work during a fitout, with a licensed electrician brought in only at the end to sign off. This approach fails consistently, and the reasons are straightforward.
The compliance pathway for a commercial electrical installation proceeds through design, installation by a licensed electrician, certification, and verification. Each stage requires specific technical knowledge and legal authority that only a licensed electrician holds.
Here is what licensed electricians bring to the tenant fitout electrical needs that no other trade can provide:
- Certificate of Compliance issuance. Only a licensed electrician can issue a Certificate of Electrical Compliance (CCEW in Victoria), which is required for the occupancy permit. Without it, you cannot legally occupy the tenancy.
- Load calculation expertise. Licensed electricians calculate the total electrical demand of your fitout and verify the building’s supply can meet it safely, preventing overloads and costly post-installation upgrades.
- Safety system design. They design and install RCDs (residual current devices, which cut power instantly during a fault), circuit breakers, and emergency lighting systems to meet both AS/NZS 3000 and Victorian building codes.
- Trade coordination. Electrical work in commercial fitouts intersects with HVAC, data cabling, fire systems, and structural elements. Licensed electricians understand these interfaces and coordinate with other trades to prevent conflicts.
- Legal accountability. If unlicensed electrical work causes injury, fire, or property damage, the tenant and property owner face significant legal and insurance liability.
Pro Tip: When engaging licensed commercial electricians for your fitout, ask specifically whether they have experience with base-building engineer submissions in Melbourne CBD or your specific suburb. This experience accelerates approvals considerably.
DIY or unlicensed electrical work in a commercial tenancy is not just inadvisable. It is illegal under Victorian law and will result in failed inspections, voided insurance, and potential prosecution.
Electrical services integration in tenant fitout project stages
Understanding where electrical work fits within the broader fitout process helps you plan your timeline and budget accurately. The fitout process and electricians are more intertwined than most tenants realise.

Tenant fitouts in Melbourne CBD towers involve two to three landlord design review cycles for electrical plans before approval, adding four to eight weeks to the programme. This is before a single cable is installed.

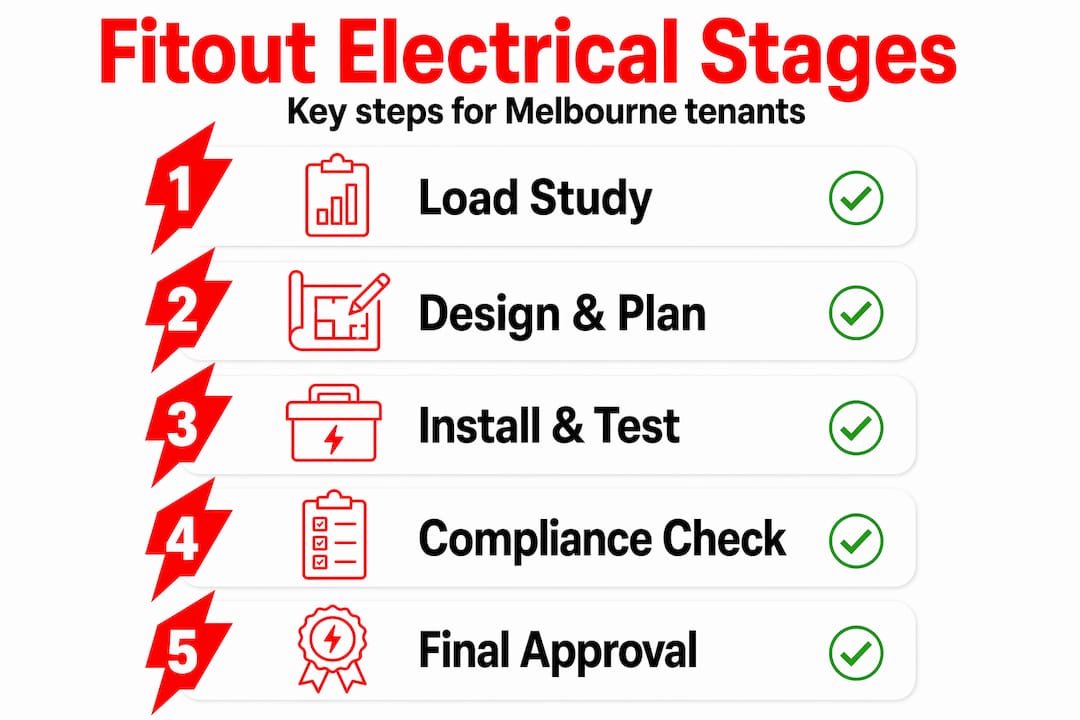

The typical electrical workflow in a Melbourne tenant fitout follows these stages:
- Pre-lease assessment. A licensed electrician reviews the base-building electrical schedule and identifies constraints or upgrade requirements.
- Schematic design. Electrical layouts are drafted to reflect the fitout’s power, lighting, and safety requirements.
- Landlord design review. Plans are submitted to the building owner and base-building engineer for review. Multiple revision cycles are common.
- Permit application. Building surveyor reviews electrical documentation as part of the broader fitout permit application.
- Installation. Licensed electricians complete switchboard modifications, circuit installations, lighting, safety switches, and data infrastructure rough-in.
- Inspection and certification. The installation is inspected and the electrician issues the Certificate of Electrical Compliance.
- Occupancy permit. Building surveyor issues the occupancy permit once all compliance documentation, including electrical certification, is received.
Electrical changes require base-building engineer sign-off and building surveyor certification before occupancy permit issuance, typically taking three to six months total. Planning your electrical inspection preparation well in advance is therefore critical.
| Fitout stage | Electrical task | Typical duration |
|---|---|---|
| Pre-lease | Load assessment and constraint review | One to two weeks |
| Design | Electrical schematic and documentation | Two to four weeks |
| Landlord review | Submission and revision cycles | Four to eight weeks |
| Permit | Building surveyor approval | Two to four weeks |
| Installation | Wiring, switchboards, lighting, safety switches | Three to six weeks |
| Certification | Inspection and compliance sign-off | One to two weeks |
Pro Tip: Engage your commercial electricians at the same time as your fitout architect or designer, not after. Electrical constraints often reshape spatial layouts, and discovering this early saves costly redesign fees.
Summary: why hiring an electrician is crucial for Melbourne tenant fitouts
The role of electricians in fitouts is not peripheral. It is foundational. Every stage of a commercial tenant fitout in Melbourne depends on electrical decisions made correctly and early.
Here is a concise summary of why engaging licensed electricians matters for your fitout:
- Legal compliance. AS/NZS 3000 and Victorian building regulations require all commercial electrical work to be designed, installed, and certified by licensed electricians.
- Safety. Properly designed electrical systems protect occupants, equipment, and the building from fire, electrocution, and overload hazards.
- Cost control. Early load calculations prevent expensive post-installation upgrades and rework caused by underestimating the building’s electrical capacity.
- Timeline management. Early electrician involvement smooths landlord approvals, engineer submissions, and occupancy permit processes, keeping your fitout on schedule.
- Occupancy permits. Without a Certificate of Electrical Compliance from a licensed electrician, building surveyors will not issue an occupancy permit.
The commercial electricians benefits extend well beyond the installation itself. They protect your investment, your lease, and the safety of everyone who will use the space.
Why early electrician engagement beats waiting to the fitout phase
Here is something most fitout guides will not tell you. The biggest electrical problems in Melbourne tenant fitouts are not caused by bad electricians. They are caused by good electricians being brought in too late.
The standard industry approach is to finalise the fitout design, engage a builder, and then bring in an electrician to execute the electrical component. This sequence feels logical. It is not. By the time the electrician reviews the plans, the spatial layout is fixed, the lease is signed, and any building electrical constraints become the tenant’s problem to solve at their own cost.
Experts say load calculations should be done before signing leases to avoid the majority of older buildings needing costly upgrades. This is advice that most tenants receive only after they have already committed to a space that cannot support their electrical requirements without significant additional expenditure.
Early electrician engagement does several things that late engagement cannot. It reveals hidden building electrical constraints before you are contractually obligated to a tenancy. It gives your designer accurate parameters for power and lighting layouts, preventing the need to relocate workstations or equipment after installation. It compresses the landlord approval timeline because the electrical documentation is ready when the broader design submission is made, rather than arriving weeks later as a separate revision.
There is also a less obvious benefit. Landlords and building managers respond more favourably to tenants who present complete, professionally prepared electrical documentation from the outset. It signals that the fitout will be managed properly, which can influence the speed of approvals and the landlord’s willingness to accommodate requests.
The electrical planning blog at Electrical Powerhaus covers this topic in more detail for Melbourne business owners navigating complex fitout programmes. The core message is consistent: treat electrical planning as a design input, not a construction output.
Electrical Powerhaus: your partner for Melbourne tenant fitout electrical needs
Tenant fitout electrical work demands more than a licensed electrician who can run cables. It requires professionals who understand Melbourne’s regulatory environment, landlord submission processes, and the technical complexity of modern commercial spaces.
Electrical Powerhaus provides end-to-end electrical services for commercial tenant fitouts in Melbourne, from pre-lease load assessments through to final certification. Our licensed electricians handle switchboard upgrades, safety switch installations, circuit breaker installation and repair, and full lighting installation and repairs for commercial spaces. We coordinate directly with base-building engineers and building surveyors to keep your approval process on track. If you are planning a tenant fitout and want to avoid the delays and costs that come from inadequate electrical planning, contact Electrical Powerhaus today for a consultation.
Frequently asked questions
Is it mandatory to hire a licensed electrician for tenant fitouts in Melbourne?
Yes. Victorian regulations and AS/NZS 3000 require all commercial electrical work in tenant fitouts to be performed and certified by licensed electricians to ensure safety and compliance. There are no exceptions for minor works in a commercial tenancy.
What happens if electrical compliance is not met during a tenant fitout?
Non-compliance can result in failed inspections, costly rework, project delays, fines, and refusal of occupancy permits, since building surveyor certification is required before any commercial tenancy can be legally occupied.
How long does the electrical approval process usually take in a Melbourne tenant fitout?
Generally, the process including design reviews, engineer sign-offs, and building surveyor certification takes between three and six months, so planning this early is essential to avoid delaying your move-in date.
Can I do some electrical work myself during my tenant fitout?
No. For safety, legal, and insurance reasons, all commercial electrical work must be completed by licensed electricians, as the compliance pathway requires installation and certification by a licensed professional at every stage.
What is a Certificate of Compliance and why is it important?
It is an official document confirming that all electrical work meets regulatory and safety standards, and it is required by building surveyors before an occupancy permit is issued, as licensed electricians are the only professionals authorised to issue it for commercial installations.
